Project by
Location
Fitzroy, Victoria
Year of completion
2021
Project cost
5m+

Awards and
recognition

2023
Global Mark
AS/NZS ISO 9001 Certified Quality Management System
2023
Global Mark
AS/NZS ISO 45001 Certified OH&S Management System
2023
Global Mark
AS/NZS ISO 14001 Certified Environmental Management System
Visit Website

The Construction Journey for Fitzroy Ltd:


Balmain & Co were awarded the construction of Fitzroy Ltd in 2019.

Located a short walk down Gore Street from the Lyric, Fitzroy Ltd is the perfect mix of raw authenticity and an understated elegance combined with an emphasis on city views, light, space and materiality. Consisting of 82 high-end apartments, Fitzroy Ltd sits at 7-levels above ground and features a breath-taking internal courtyard, rooftop garden and a beautifully crafted entrance lobby.

Balmain & Co will be undertaking the early works for this project which involves demolition, excavation, ground preparation, piling, shotcrete, capping beam and basement slabs.

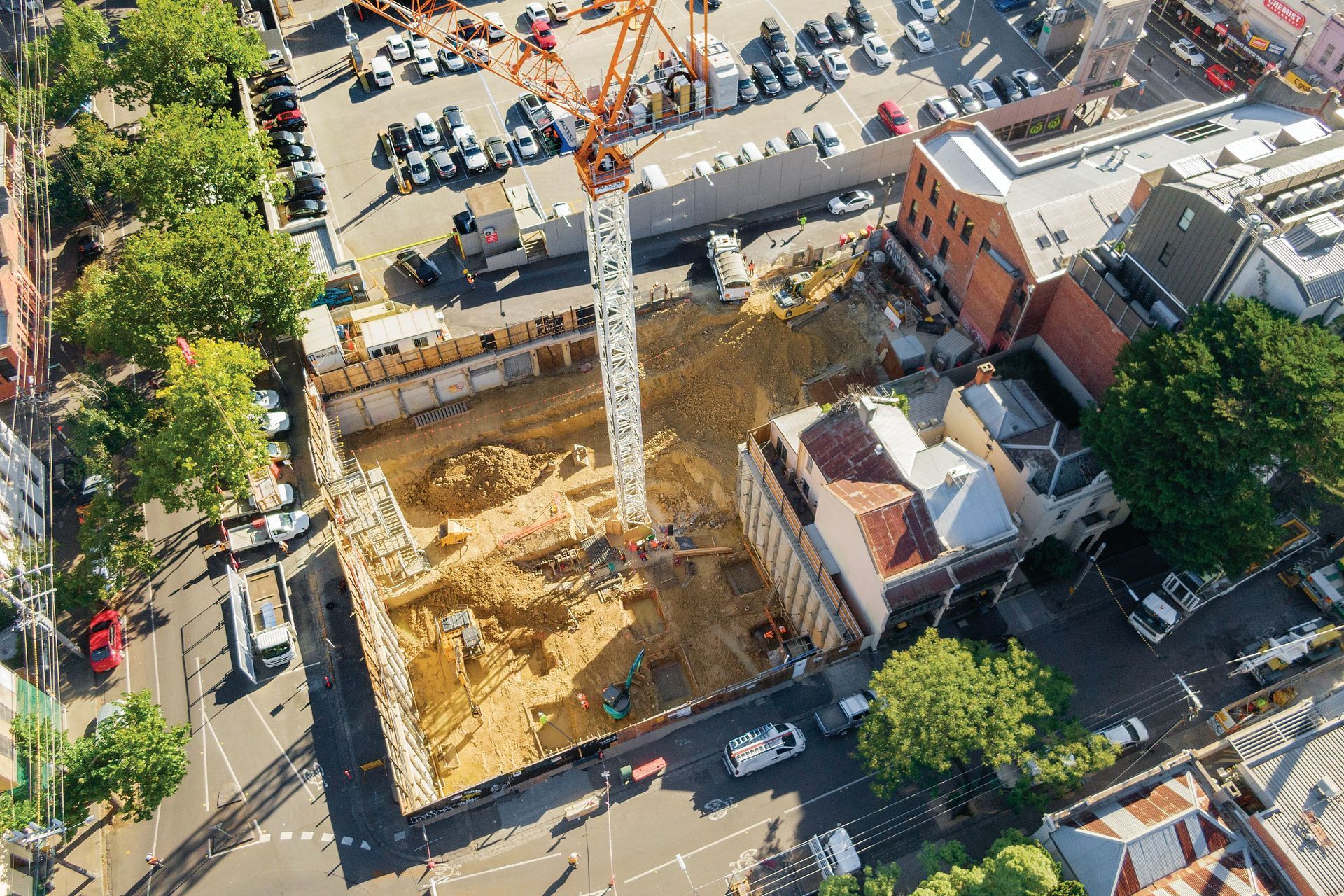

Construction Update: October 2019

Demolition has already wrapped up on site and basement works have since commenced at Fitzroy Ltd. Trucks have been running in and out this week in preparation for the piling rig due on site in the coming weeks. Next month will see piling, capping beam, bulk excavation, shotcrete and ground anchors as we make our way down to the bottom.


Construction Update: March 2020

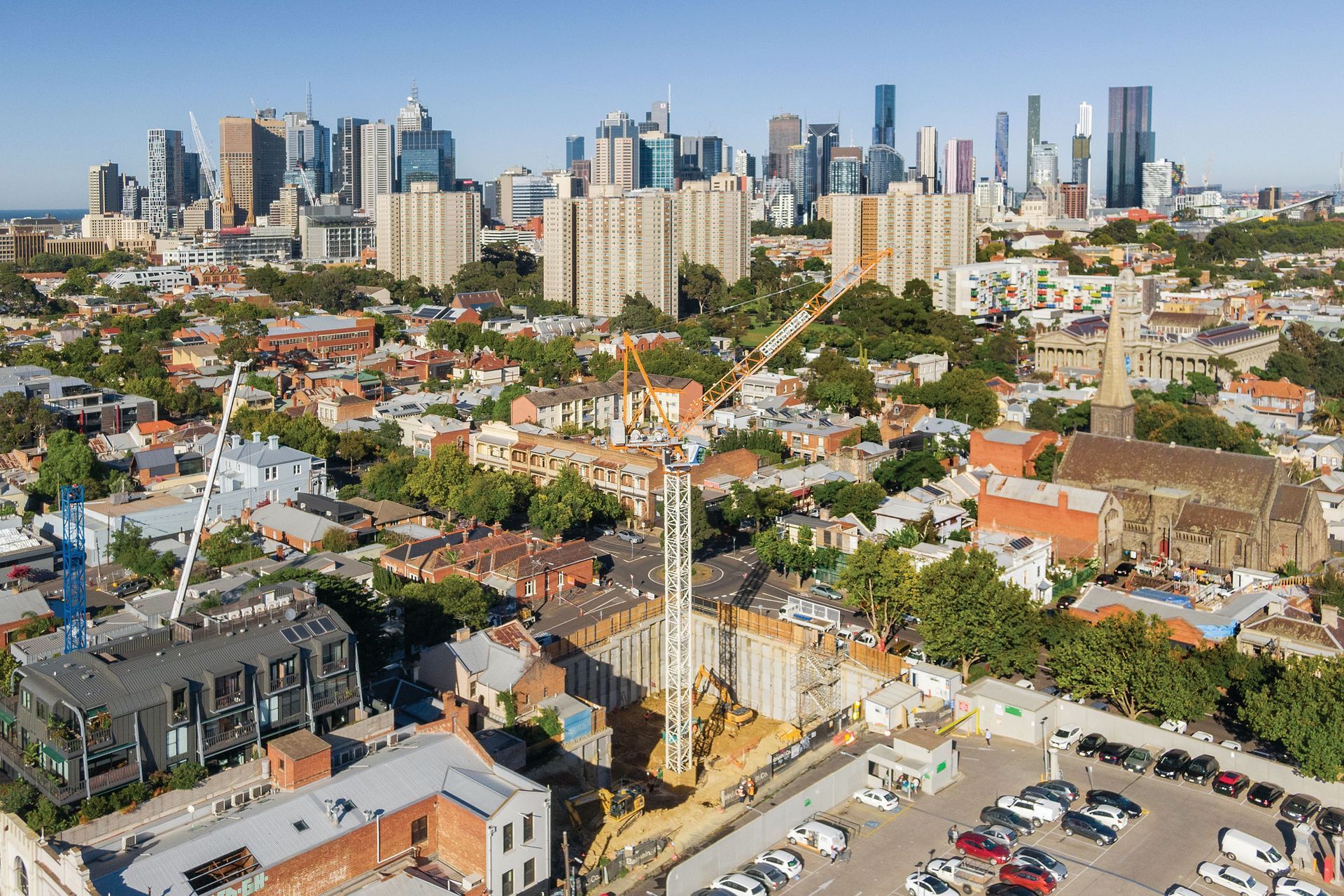

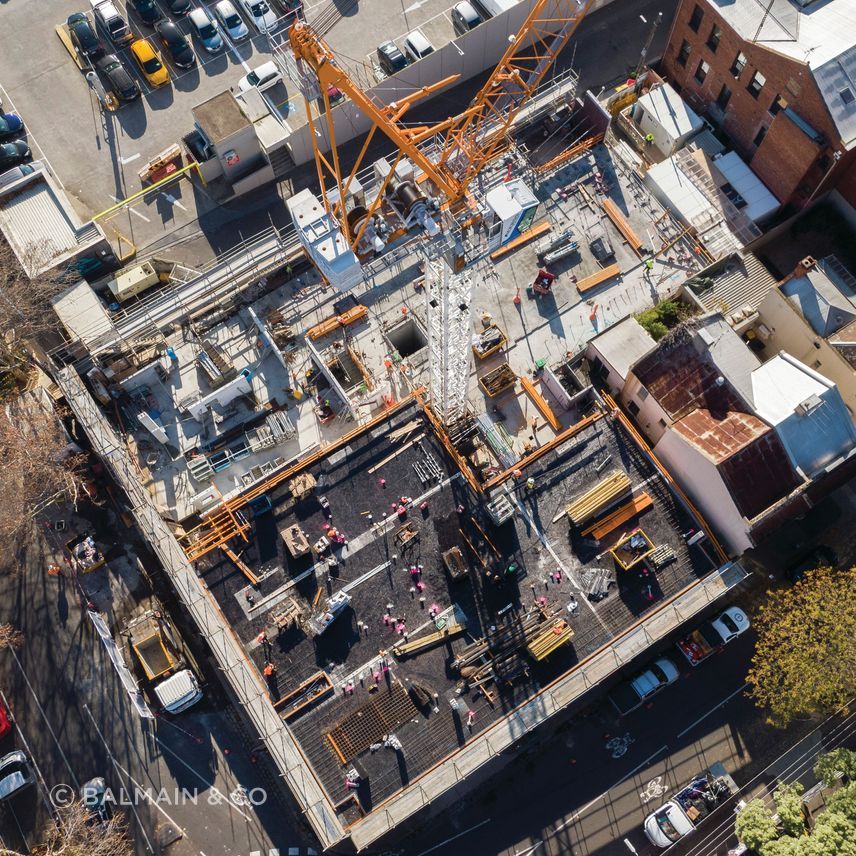

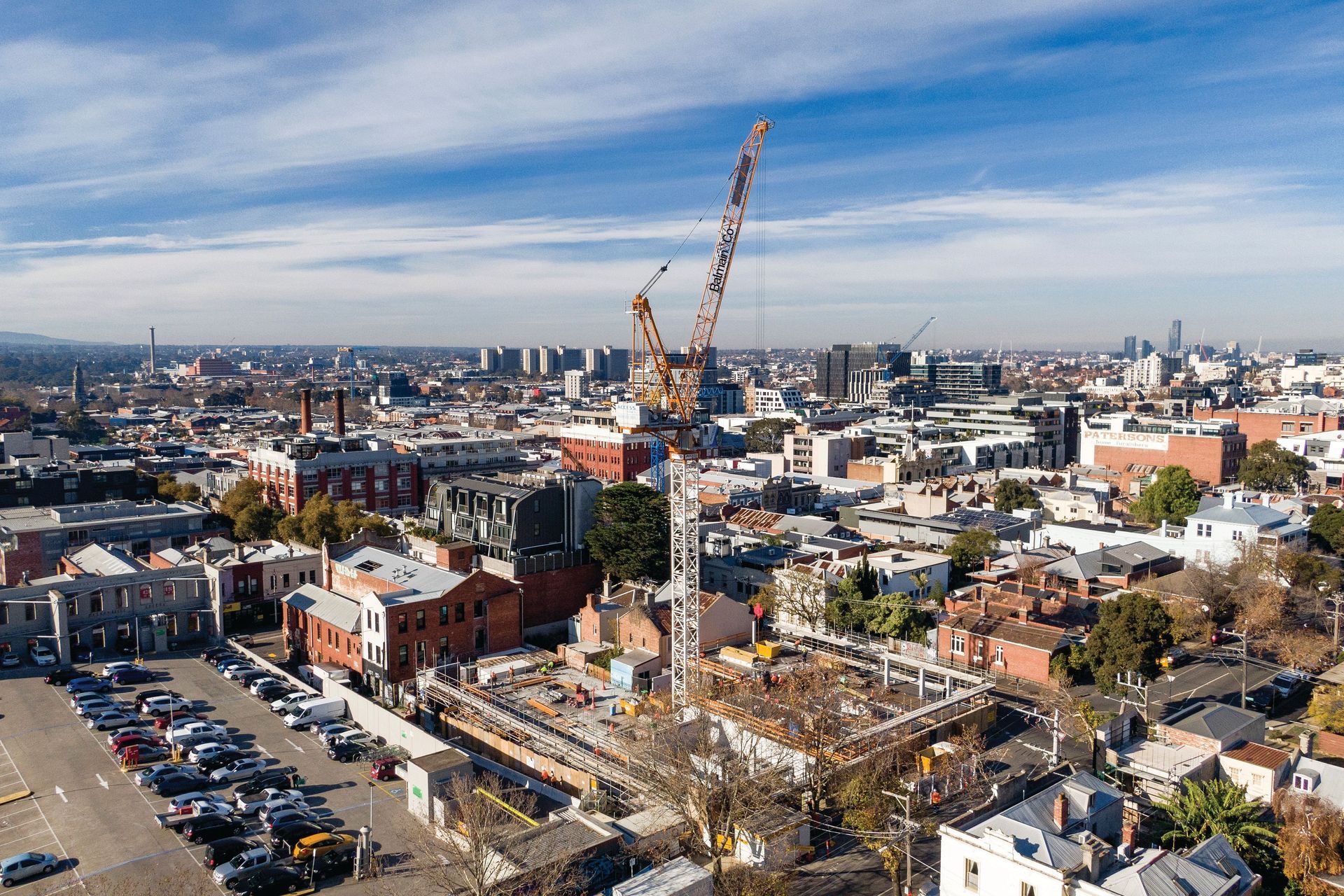

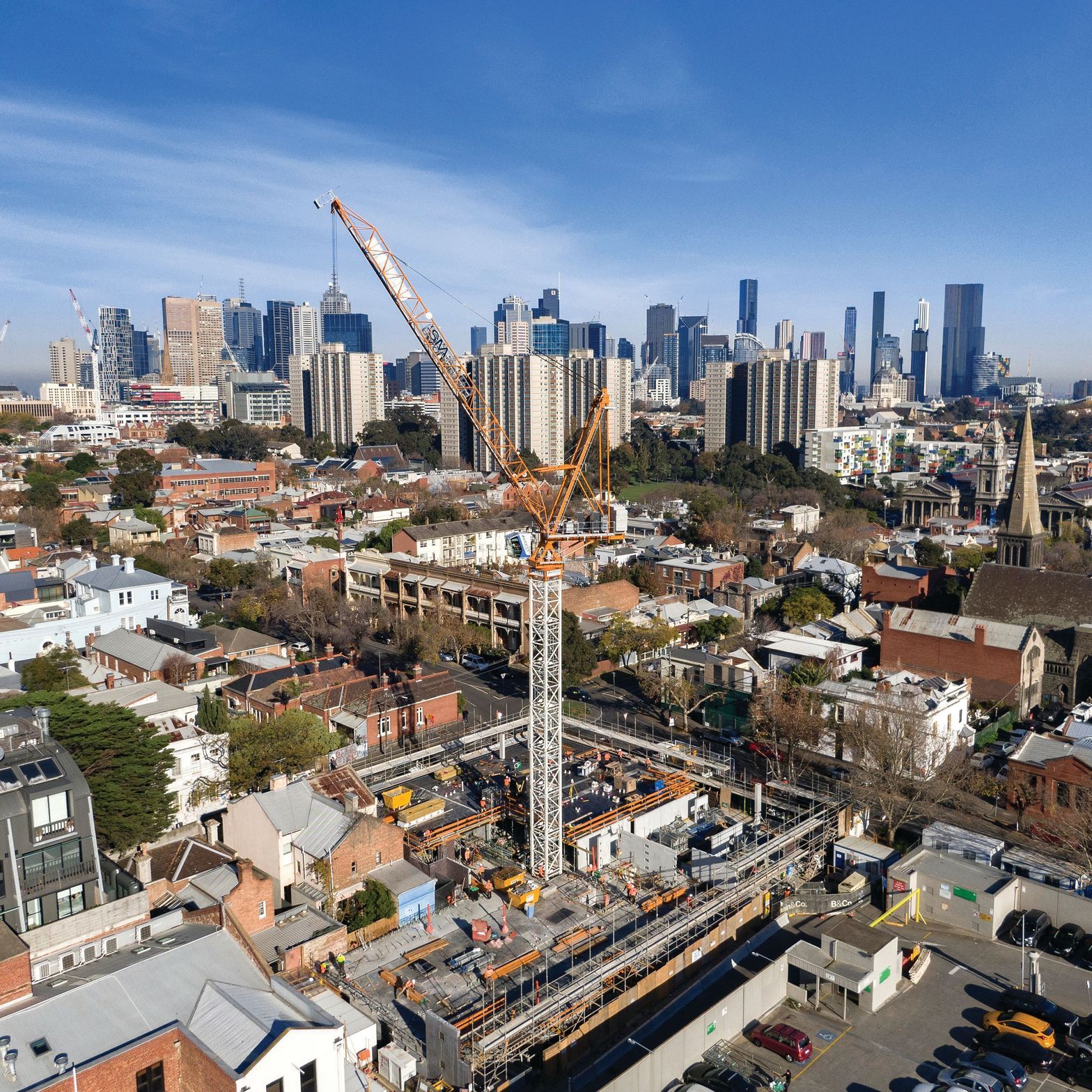

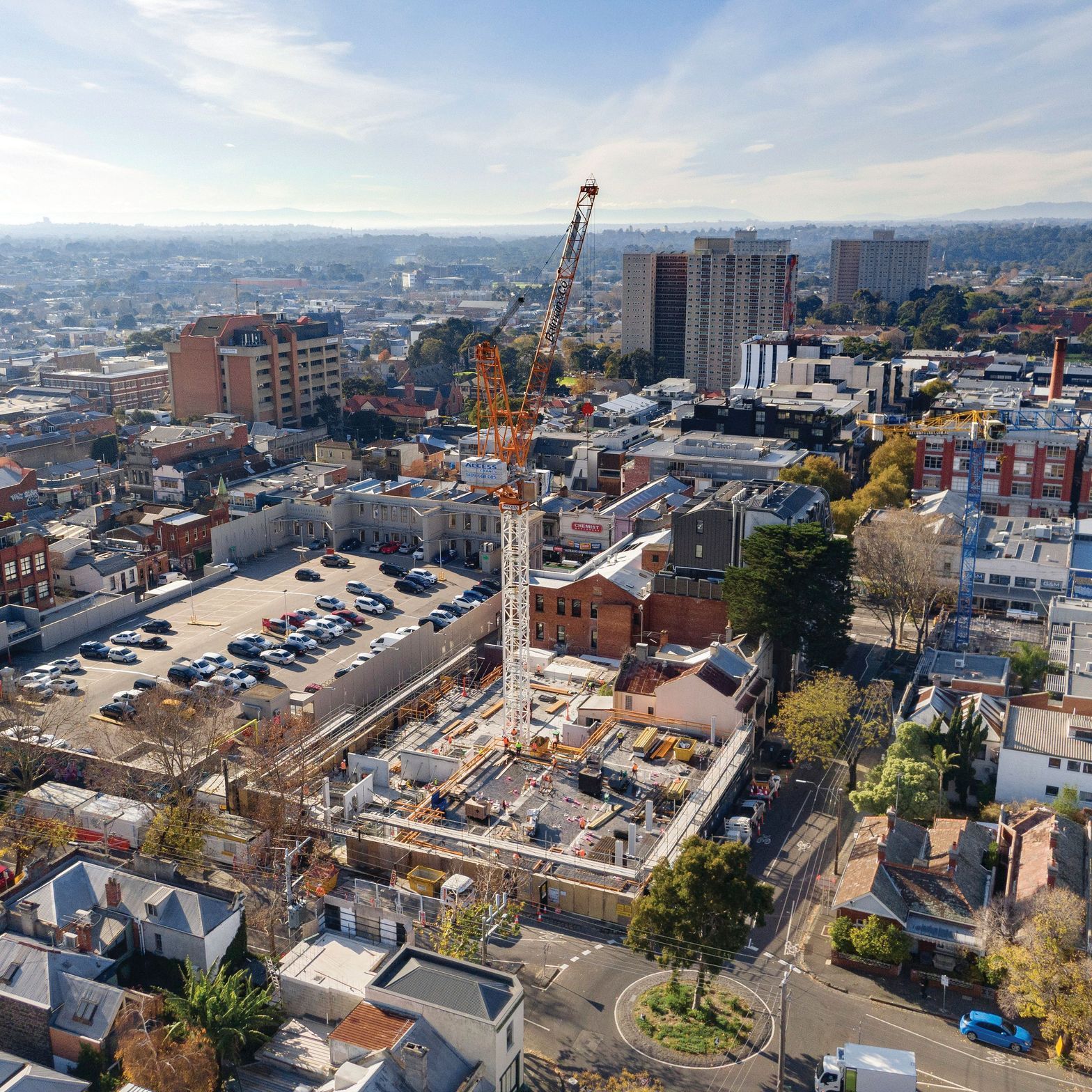

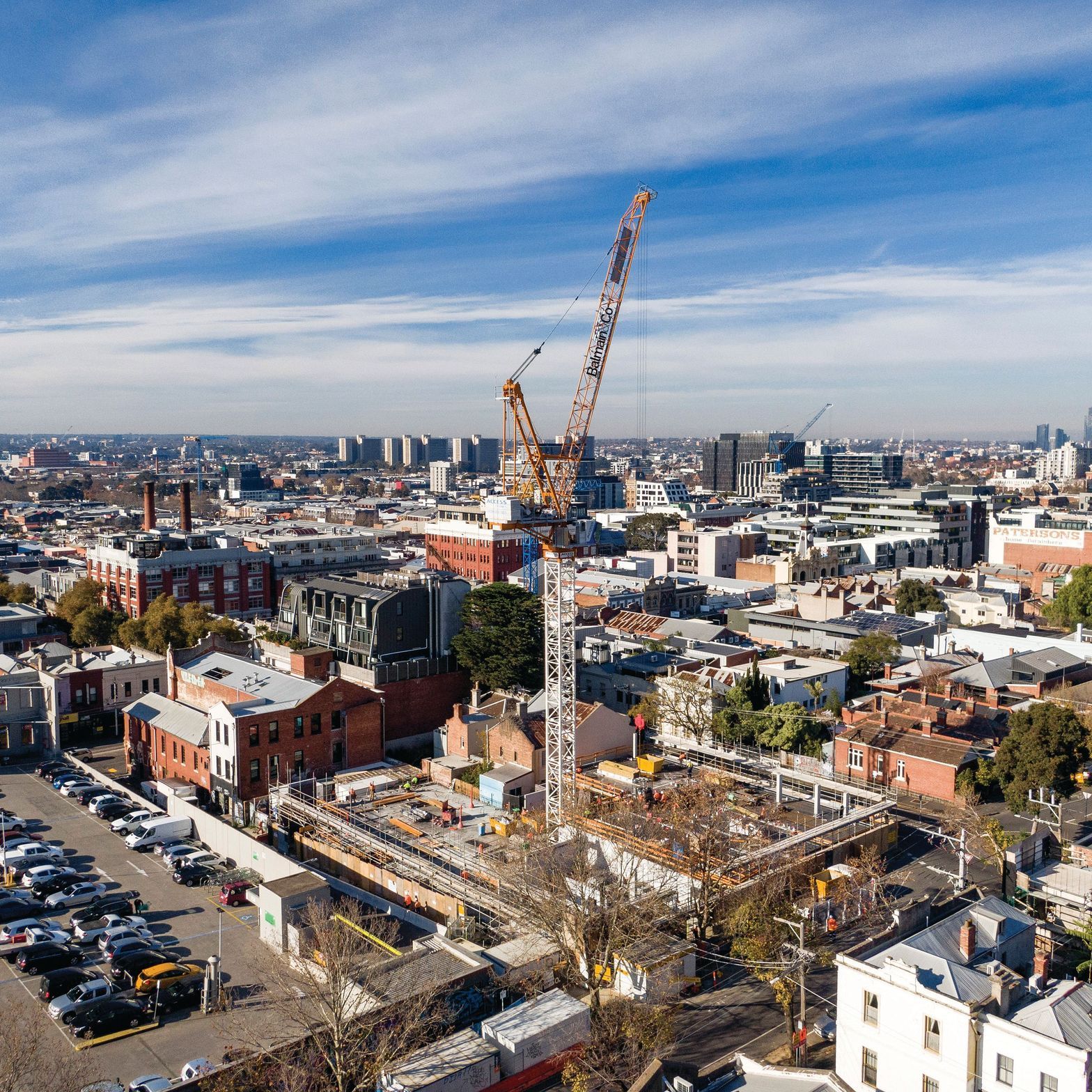

The tower crane at Fitzroy Ltd is up, marking the second Balmain and Co tower crane to grace Fitzroy’s skyline. All footings and in-ground works are complete in the car stacker pit with the slab due to be poured early next week. The final basement retention is on track for completion mid next week, with formwork set to commence on suspended levels shortly after.

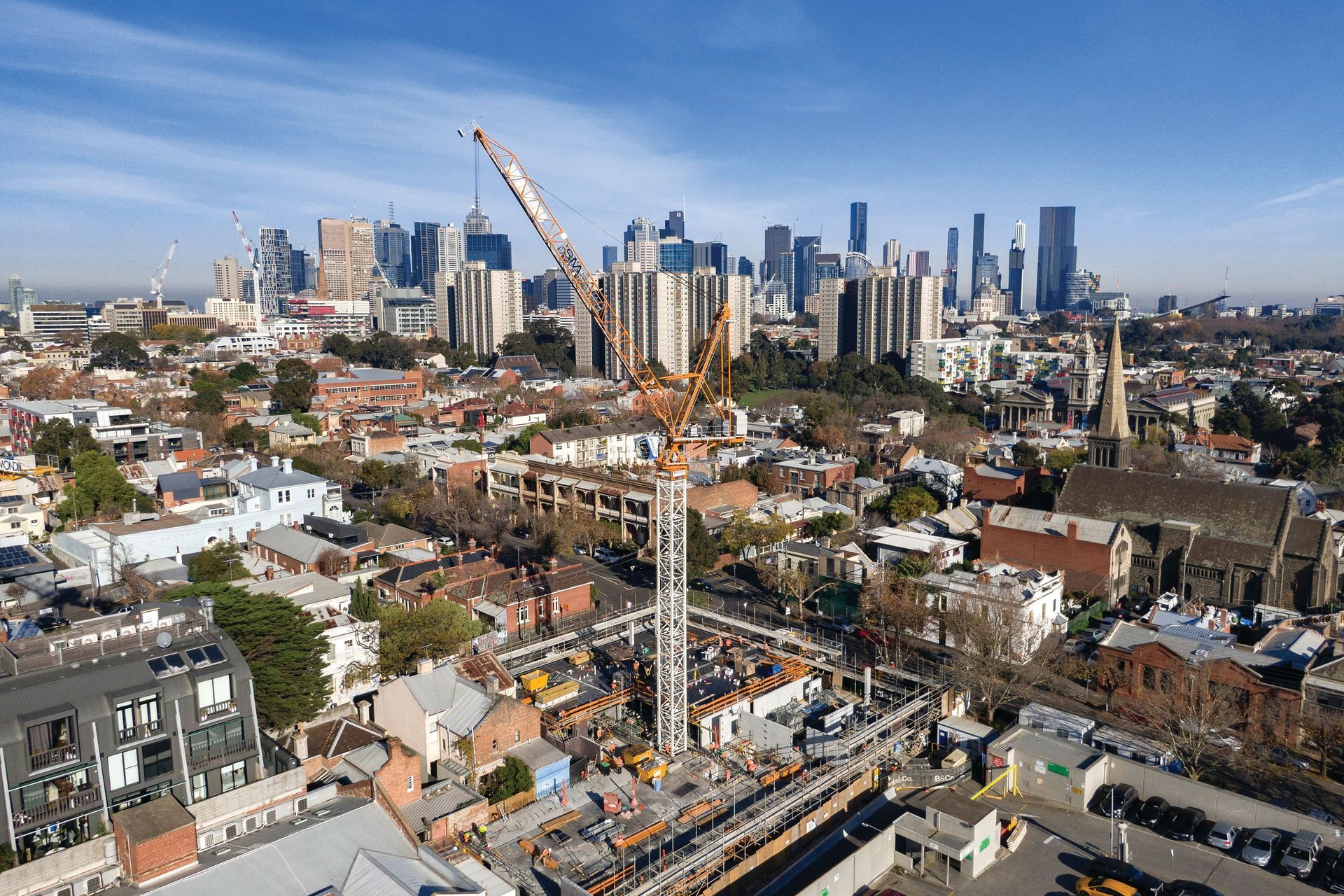

Construction Update: June 2020

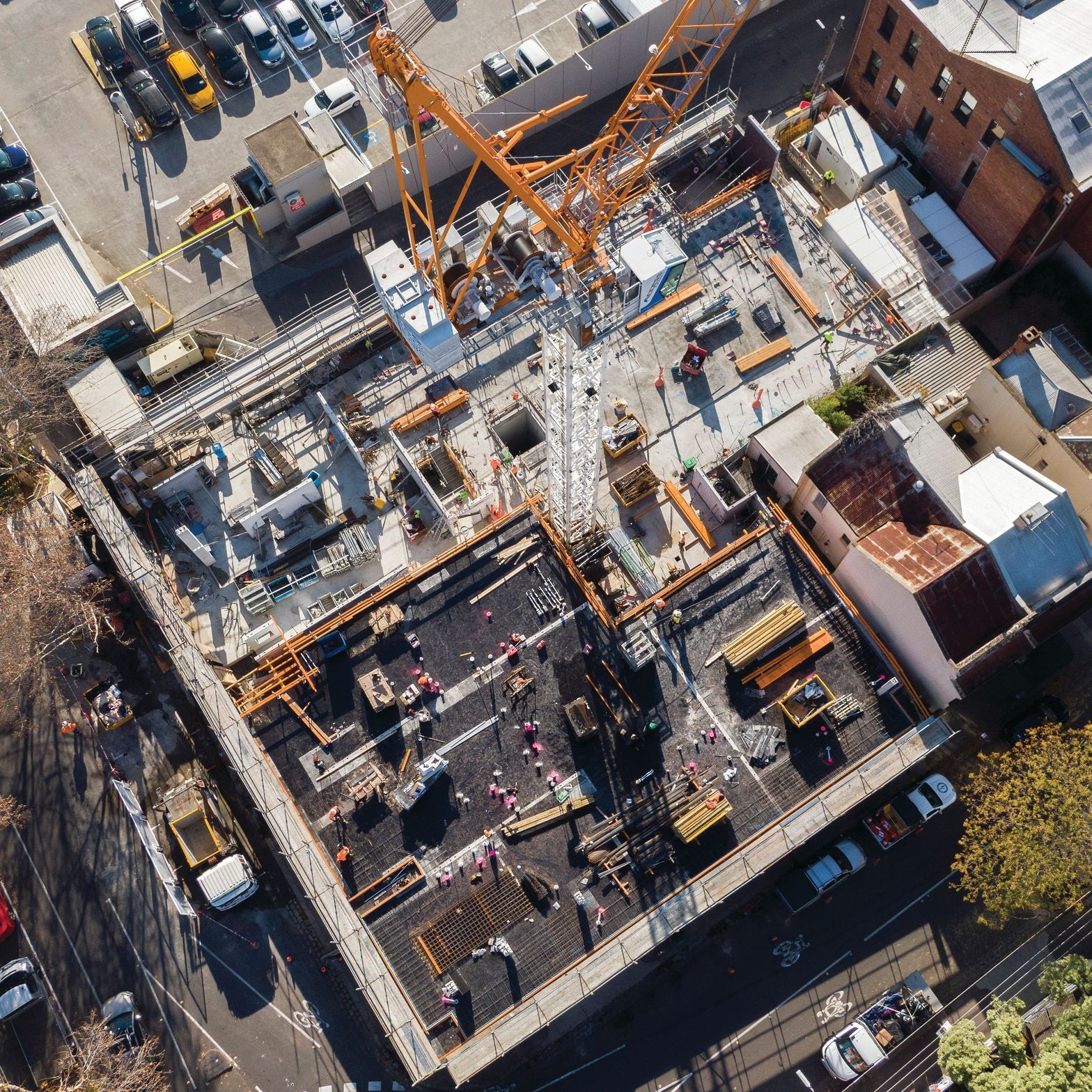

The structure is moving along quickly for Fitzroy Ltd with Level-1 complete and Level-2 due for completion before the month’s close. Basement works have begun with services and car stackers due to commence at the end of June. Formwork stripping for the apartments will take place next month with apartment fit-out to follow.

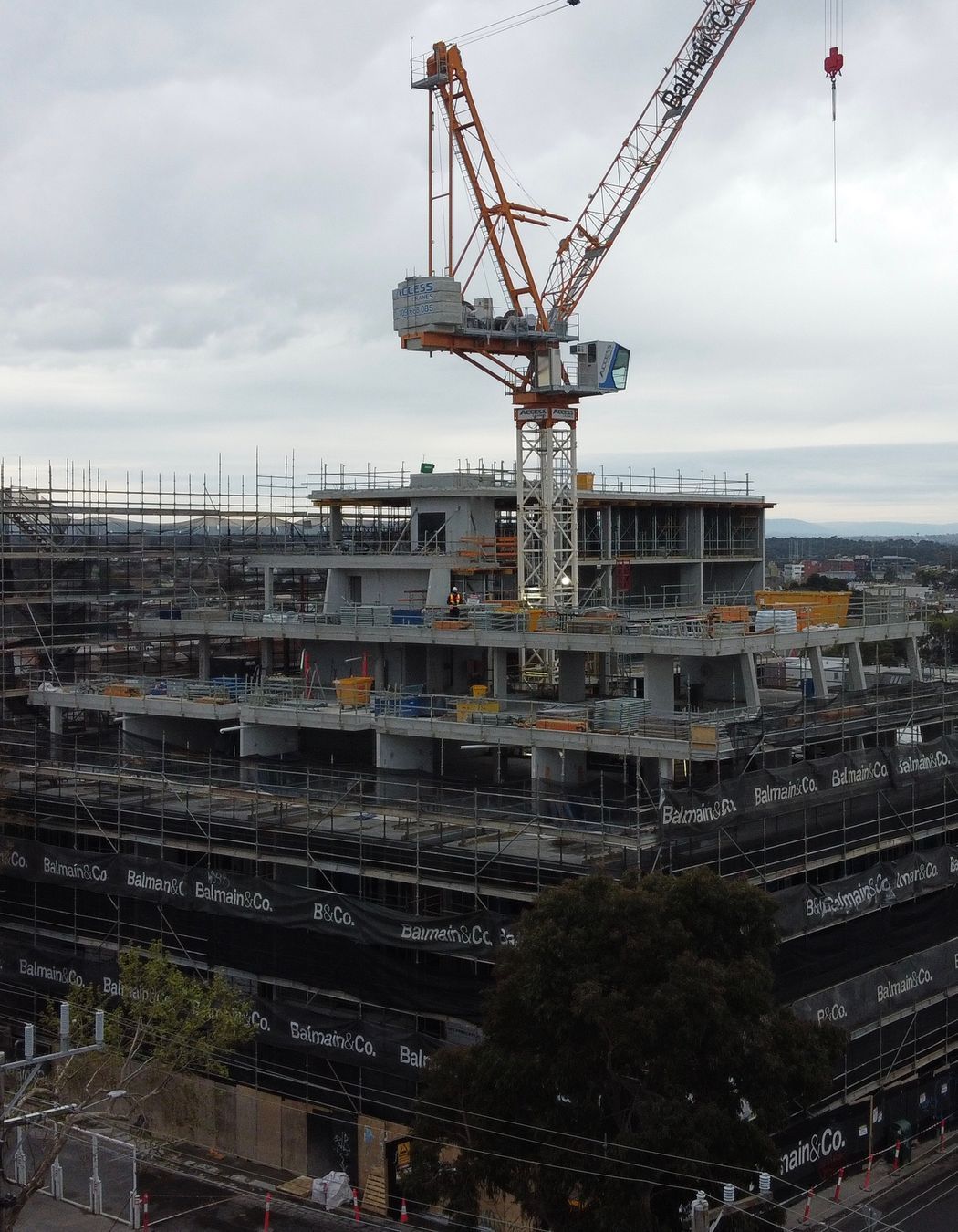

Construction Update: September 2020

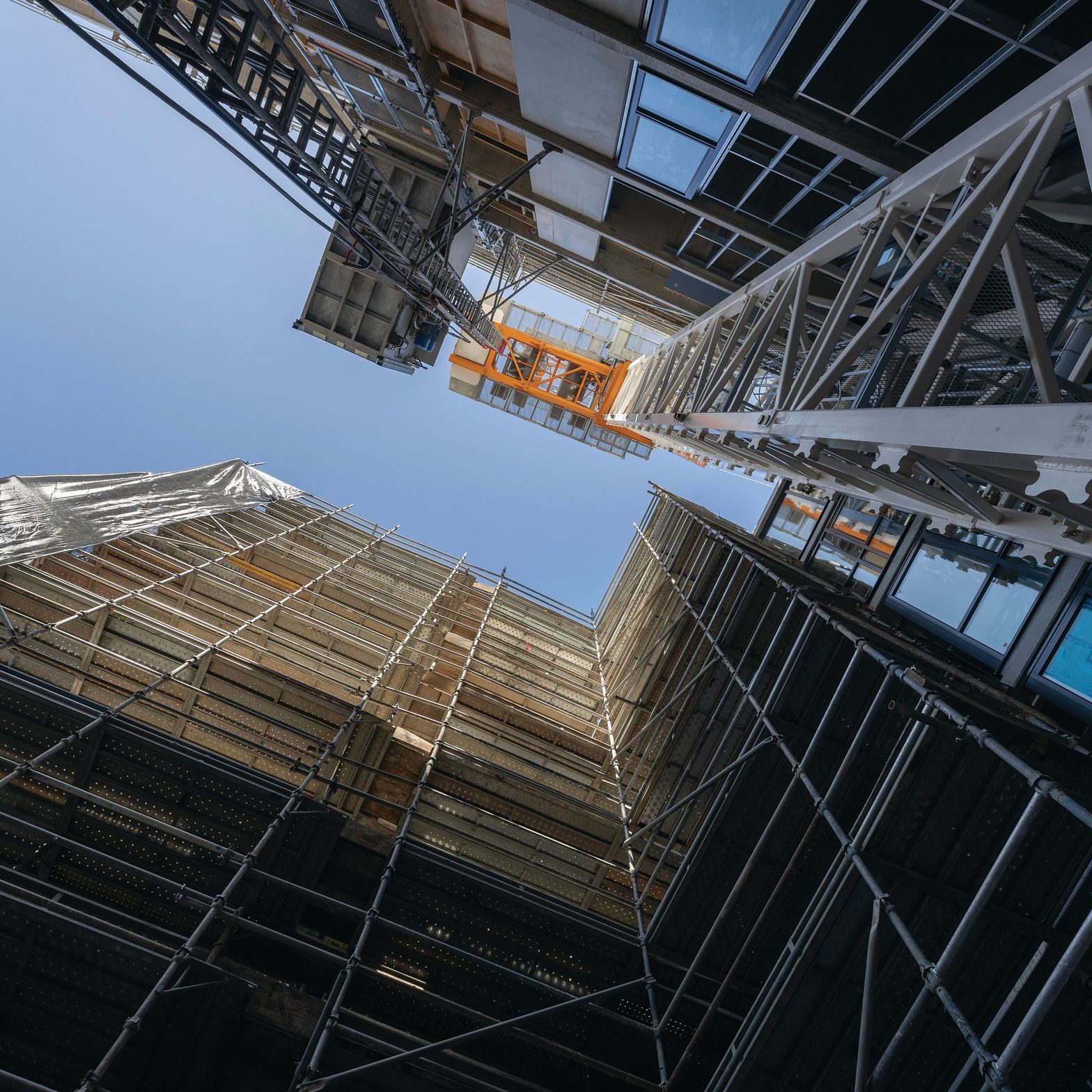

The structure topped out at Fitzroy Ltd with the final roof pour taking place at the end of August. The structure for the car stacker is also nearing completion with the electrical and mechanical stage to commence in the coming weeks. External facade works have now commenced, with the hand-laid brick and metal cladding taking shape. Internally, services and framing is complete up to Level-3 with progress to continue up the building.

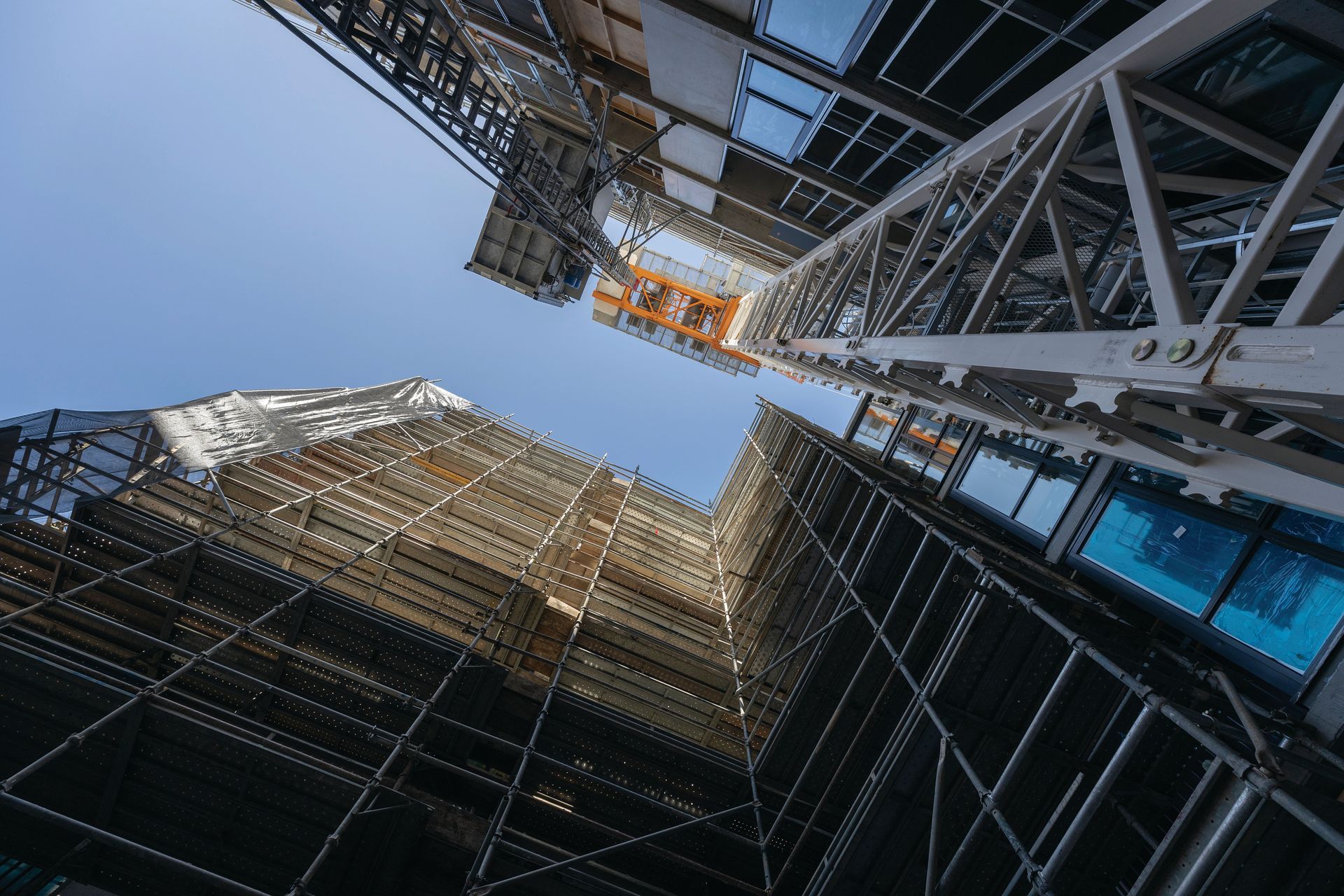

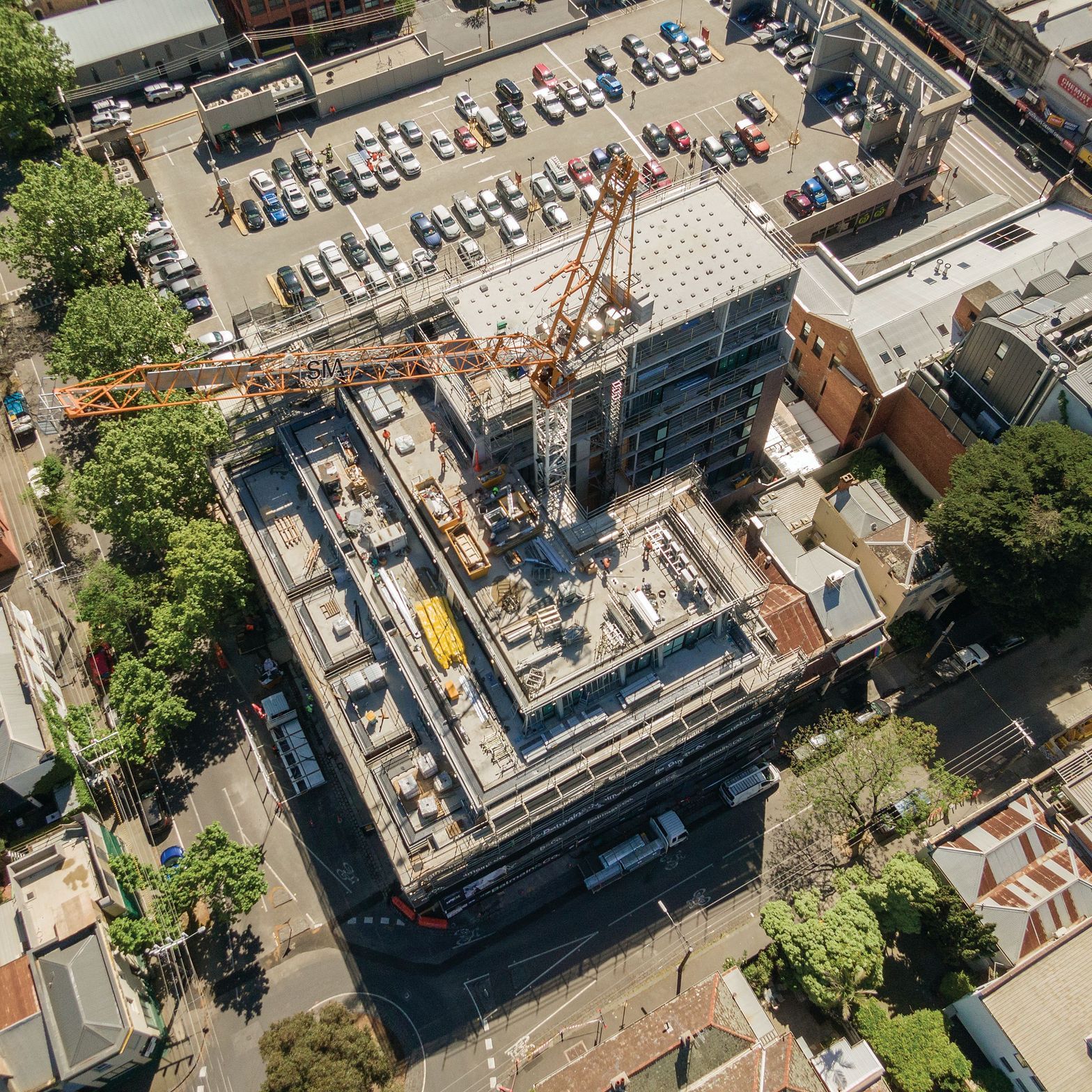

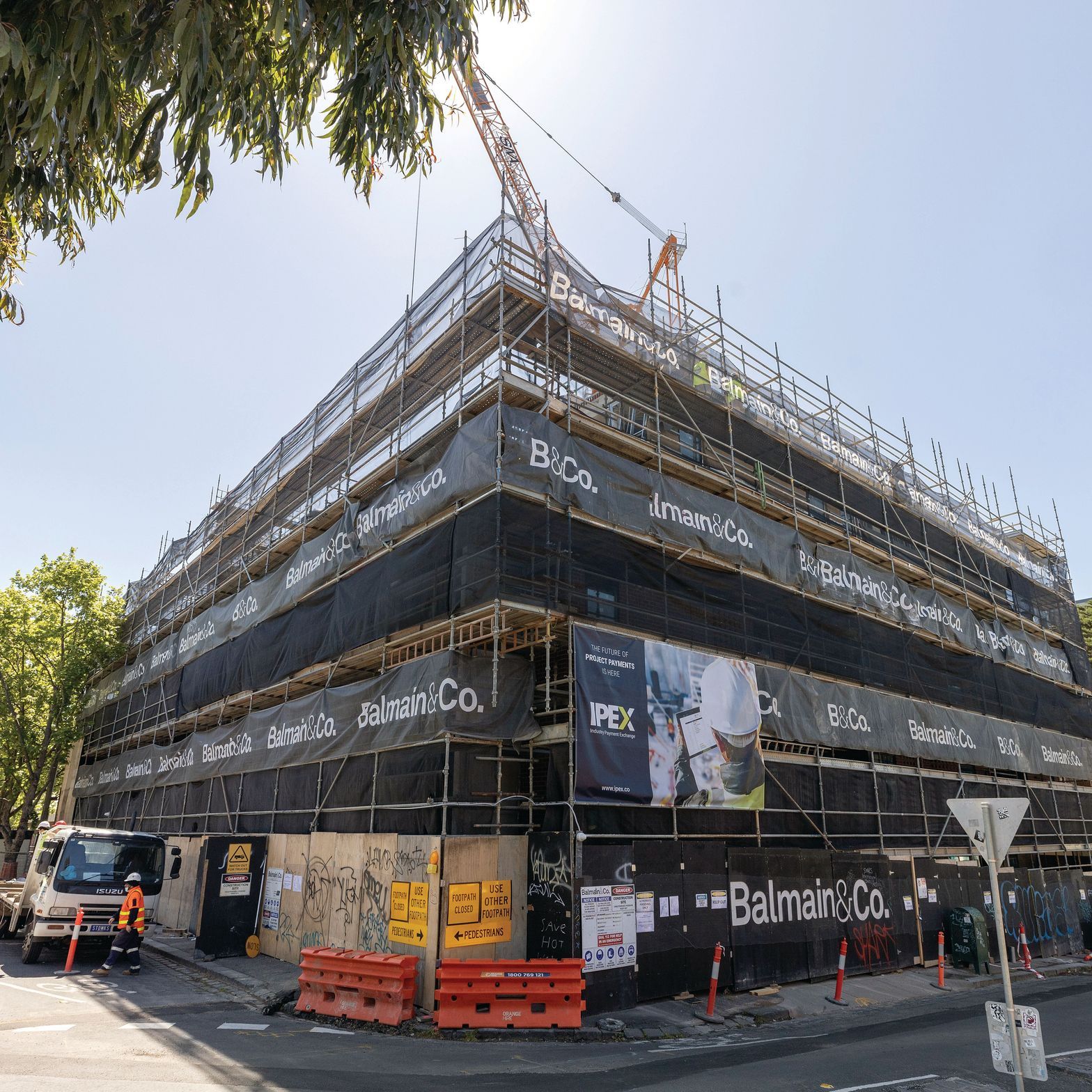

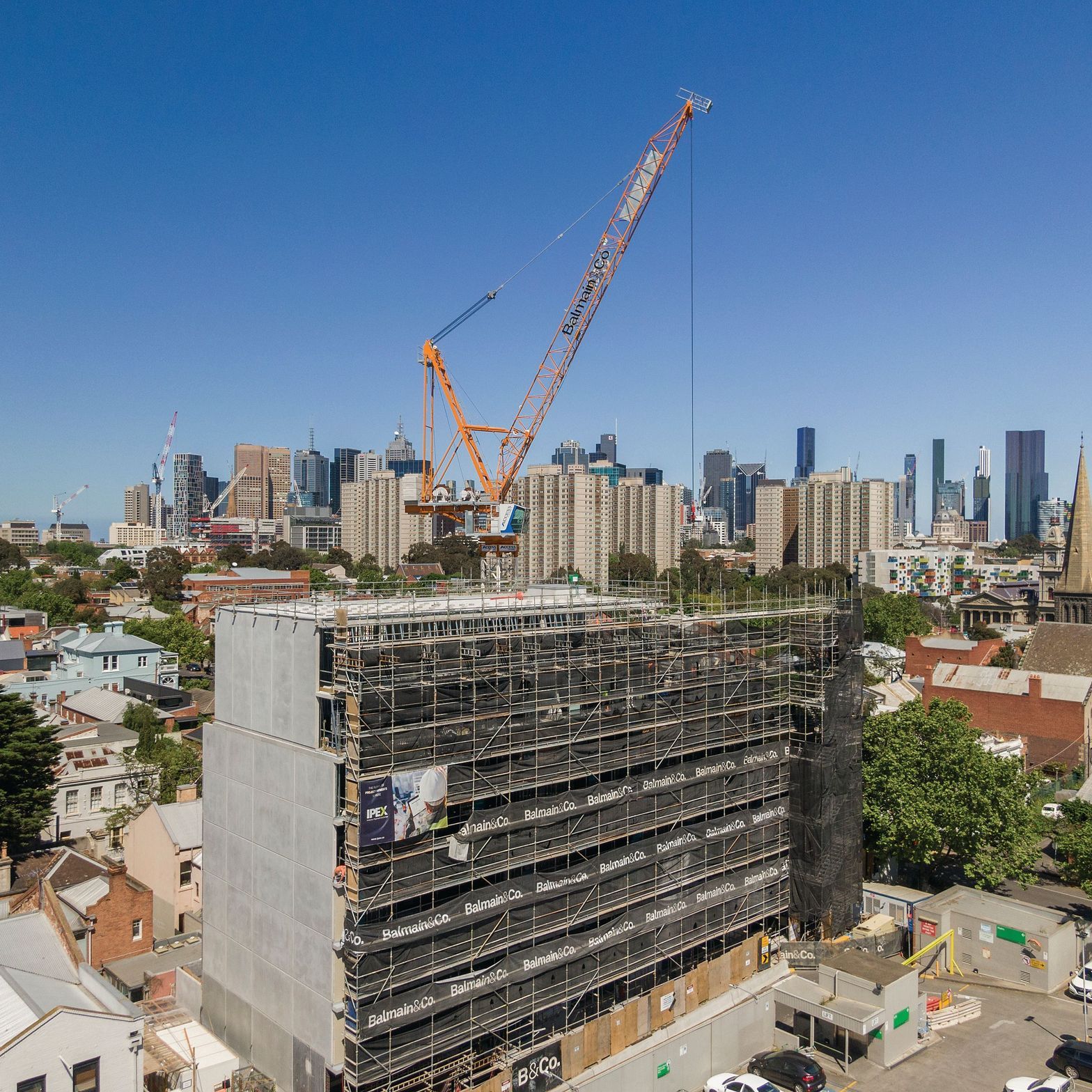

Construction Update: October 2020

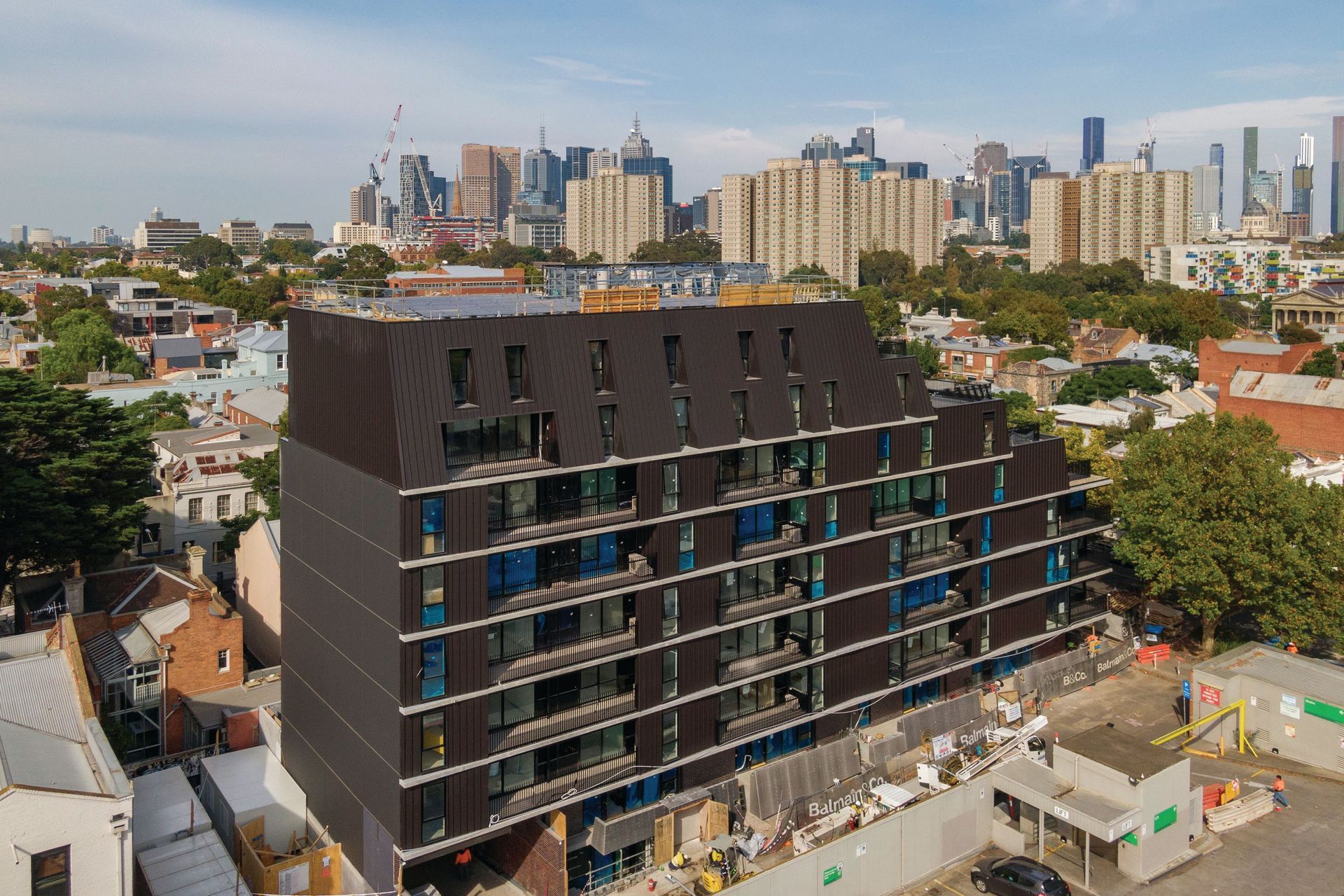

The façade is coming along nicely at Fitzroy Ltd with all brickwork and metal cladding now complete to Level-4. External balustrades are also progressing well with works complete up to Level-7. Internally, plaster and painting has commenced on ground floor and Level-1 with Level-2 through to Level-4 to follow shortly after. In the basement, the structure for the car stacker is now complete with the electrical/ commissioning currently underway.

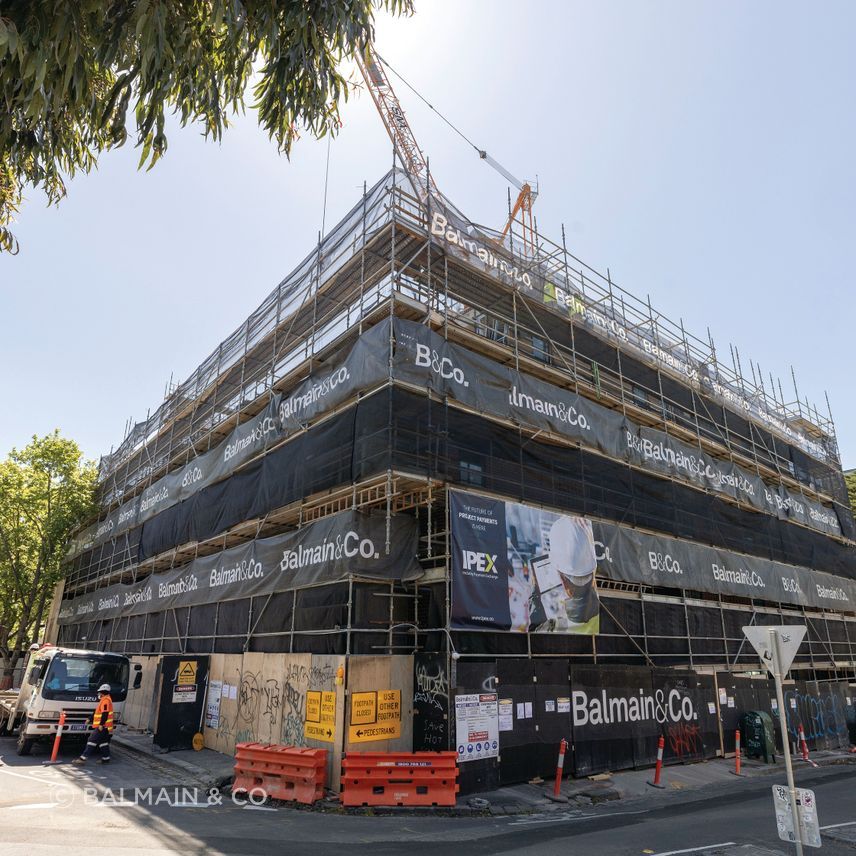

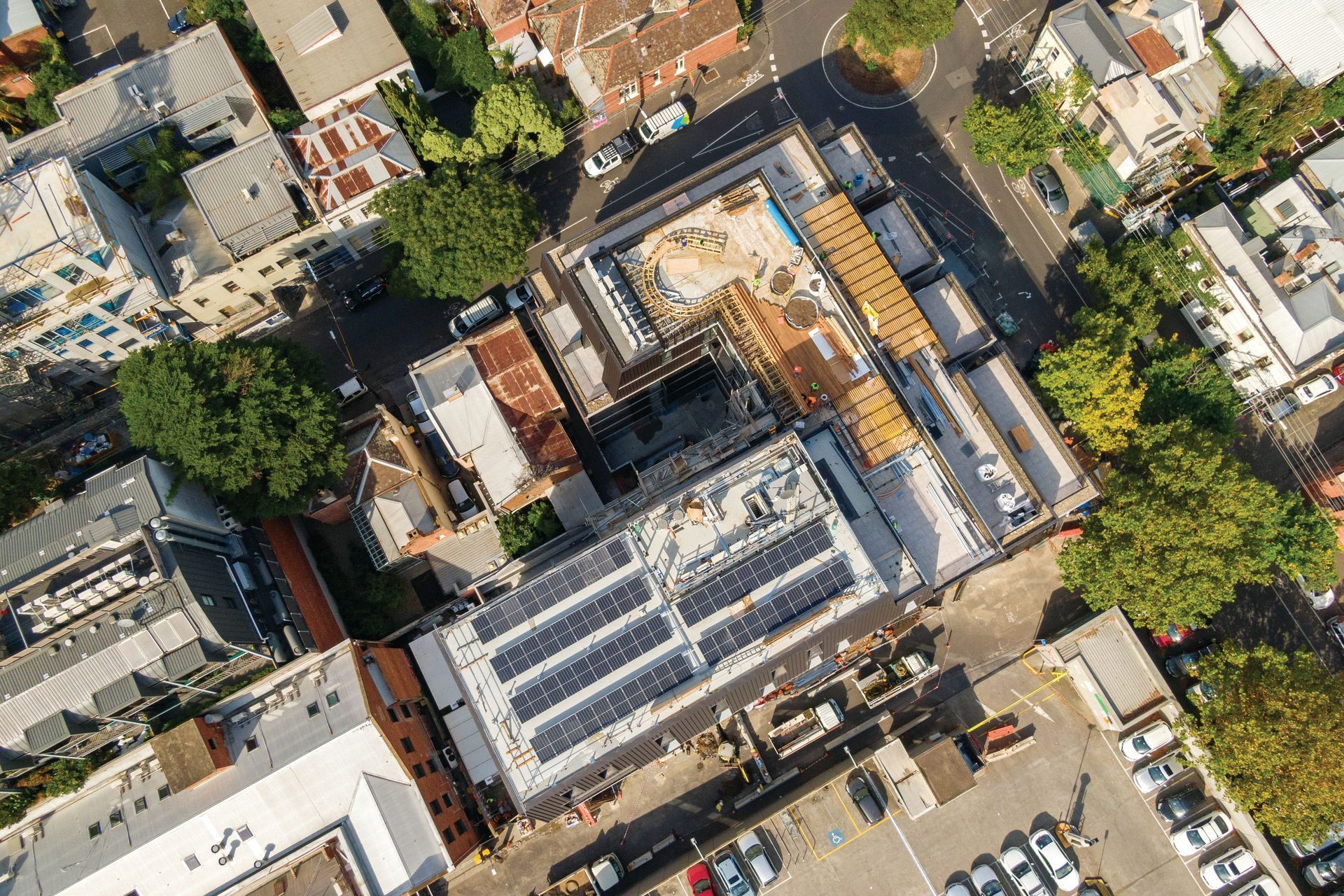

Construction Update: March 2021

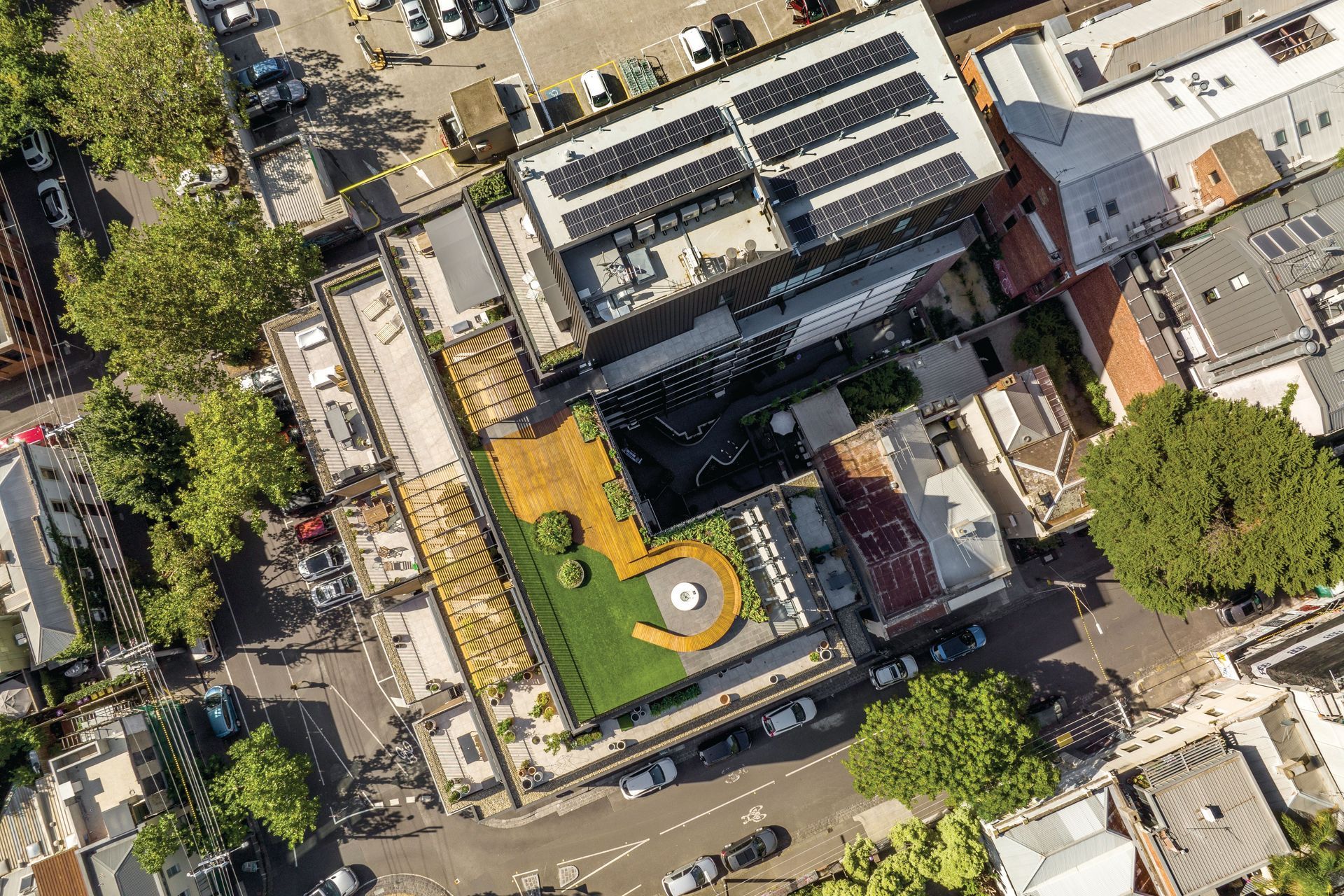

Joinery within the apartments has made great progress on site at Fitzroy Ltd with the apartments nearing completion and penthouses currently in progress. Stone and appliance installation has commenced on the lower levels along with works to the communal areas on the ground floor and level 6. Commissioning of the car stacker is now complete, and on the outside, the façade and external works are also nearing completion.

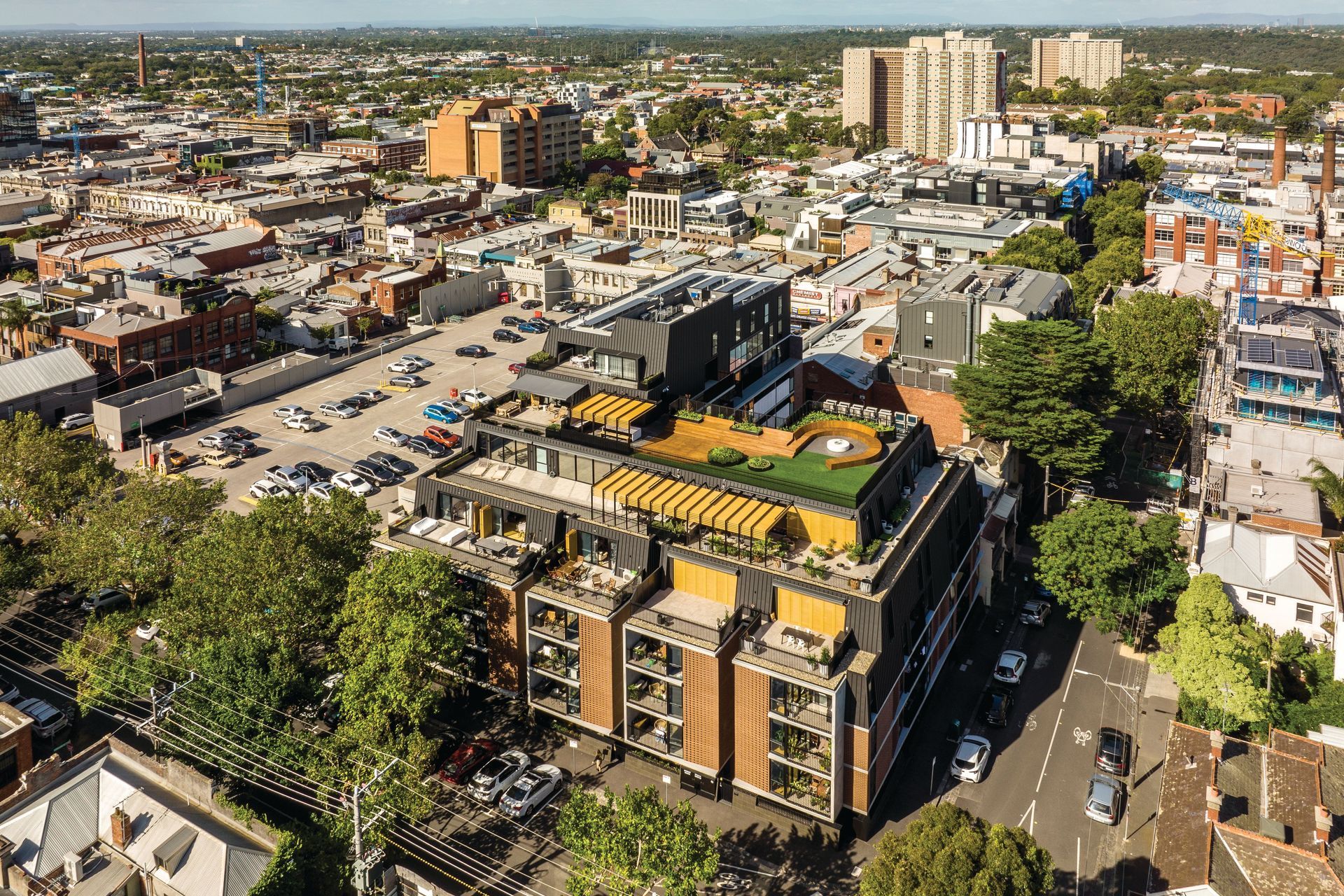

Fitzroy Ltd reached completion in August 2021

Balmain & Co | Fitzroy Ltd

About the
Professional

Balmain & Co develops and builds bespoke, contemporary projects with a commitment to controlling quality. With headquarters in Melbourne, and a construction division in Queensland, Balmain & Co collaborate with industry-leading developers and consultants on high-end residential and complex commercial developments, education, civil and infrastructure projects.

Our journey commenced in Melbourne back in 2015, with a modest office space and an ambitious vision. Since then, our team has flourished, our footprint has expanded across the nation, and we've embraced diversification, achieving significant milestones and tackling substantial projects. In 2015, our first project as Balmain & Co had a value of $10 million. Fast forward to the present; we have successfully delivered more than 40 construction projects and are actively engaged to deliver various projects, including our largest to date which has a project value exceeding $100 million.

Balmain & Co provides an end-to-end service, throughout the design, build and afterlife of every project. We are committed to delivering a high-level of service to our clients and to creating long-term positive impacts on the communities that we work in. The Balmain & Co brand is renowned for excellence and our reputation for delivering absolute quality extends throughout all facets of the company.

At ArchiPro we recognise and acknowledge the existing, original and ancient connection Aboriginal and Torres Strait Islander peoples have to the lands and waterways across the Australian continent. We pay our respects to the elders past and present. We commit to working together to build a prosperous and inclusive Australia.
